Low-voltage path · Division 16: Outside-plant fiber construction · Lesson 313

Read duct proofing and occupancy records

Free for apprenticesRead it or play it. No card, no account, nothing to cancel.
Read duct proofing and occupancy records

What you should be able to do

Read a duct register together with its underlying proofing and occupancy evidence, and explain why a past pass is not permission to install a new cable.

Read The Register

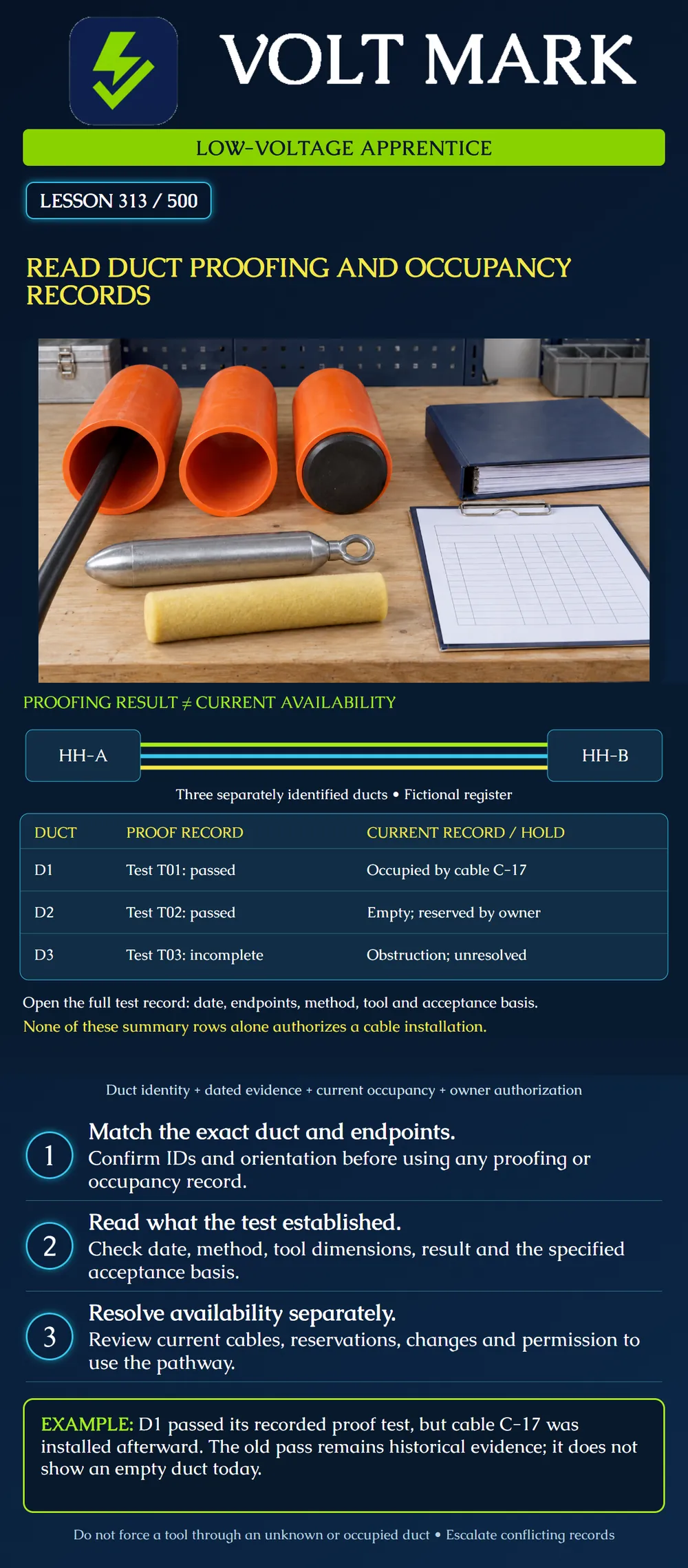

The poster shows three fictional ducts between handholes HH-A and HH-B. D1 passed test T01, but its current record identifies cable C-17. D2 passed T02 and is recorded empty, but the owner has reserved it. D3 has an incomplete test and an unresolved obstruction.

These rows summarize different kinds of information. Proofing describes a test on a specified pathway at a particular time. Occupancy records identify what is installed. Reservations and authorization describe whether the owner has assigned the pathway for the proposed work. A useful review keeps those categories separate.

The poster deliberately omits the full test detail to demonstrate why the summary cannot stand alone. Open the linked record rather than treating the word passed as a complete acceptance report.

Identity Comes First

Check both endpoint IDs, the duct ID and the orientation convention. A position described as upper-left can be ambiguous when two people view opposite ends. Use the project's defined labeling and orientation method; do not guess a matching opening.

Trace references through the route. Proof of HH-A to HH-B does not establish the condition of HH-B to HH-C. When a route contains several segments, each relevant segment needs its own evidence. Confirm whether the record describes a parent duct or an innerduct within it.

WHAT DID THE TEST SHOW? Read the date, procedure reference, test direction, tool type and dimensions, operator or witness information, result and exceptions. Compare these with the project-specific acceptance requirements. A test using the wrong tool or an unidentified duct cannot be made valid by a pass label.

Corning's air-assisted installation guidance distinguishes proofing from sponge passage: a sponge may pass a partial obstruction. The manufacturer also identifies duct cleanliness and integrity as relevant. This does not establish one universal mandrel size or test method. The actual system and approved specification determine the procedure.

A pull rope at both ends is not a complete proof record. A successful passage test also does not automatically establish every other property, such as leak tightness, suitability for a particular cable or permission for air-assisted installation. Read the test's scope.

Current Occupancy And Change History

Record installed cable IDs and associated work orders, spare or reserved assignments, and later repairs or changes. An empty status recorded before another crew's installation may now be outdated. Resolve contradictory dates and physical identification through the responsible records owner and authorized field-verification process.

Do not erase a historical pass simply because the duct was later occupied. Preserve the original evidence and add the later event. The useful question is what the combined record demonstrates now.

Original Timeline Exercise

For fictional D1:

  • Training day 1: test T01 completed under the specified procedure.
  • Training day 3: cable C-17 installed; installation record links it to D1.
  • Training day 5: a new crew reviews the original proof sheet.

The day-5 crew cannot call D1 empty based on the day-1 result. Its review must include the day-3 installation. This timeline teaches evidence interpretation; it does not say whether a second cable could ever be designed for that duct. That requires a separate compatibility, capacity and installation review.

For D2, a reservation is not an obstruction, but it is still a constraint on use. Obtain the owner's disposition rather than treating empty as unassigned. For D3, incomplete is not passed. Record the unresolved issue and the responsible follow-up.

Worked through

Use these fields on a training record: route segment; both endpoints; duct/innerduct ID; orientation; drawing revision; test record ID and date; method/tool; acceptance reference; result and exceptions; present cable IDs; reservation; subsequent work; owner decision; and unresolved questions.

Create a clear link to original test evidence. Keep corrections traceable and distribute approved updates to the people relying on the records. Do not replace detailed evidence with a single green status icon.

Safe Boundary

This lesson teaches document review. It does not authorize rodding, compressed-air proofing, opening a vault or entering an excavation. Do not force a tool into a pathway that may contain live services or whose identity is uncertain. Refer testing and obstruction investigation to the trained, authorized crew.

Knowledge Check

  1. Does passed mean currently empty? No.
  2. Does empty mean available for your project? No.
  3. Is sponge passage necessarily equivalent to required proofing? No.
  4. Does one segment's record prove the entire route? No.
  5. Should later occupancy erase a historical test? No; retain both with dates and links.
  6. What should happen to incomplete results? Keep them unresolved until the required follow-up is documented.

Worked through

Review the fictional register for a proposed new cable on training day 5. D1 has a historical pass, but the later C-17 installation makes an empty-pathway conclusion unsupported. D2 is recorded empty and passed, yet its reservation requires the owner's disposition before assignment. D3 has no completed passing result and an unresolved obstruction. Therefore none of these three summary rows alone establishes a released pathway for the proposed installation. Keep the original test links, add the relevant occupancy or reservation evidence, and list the unresolved decision for each duct. This is a records conclusion, not a declaration that all three ducts are physically unusable.

Where beginners go wrong

  1. Mistake: Copying D1's day-1 passing result into the day-5 work package as evidence that the duct is empty. Correction: Link the day-3 C-17 installation record as well as the proof sheet. Report the documented occupancy and request a separate review of the proposed use; retain the historical test rather than overwriting it.
  1. Mistake: Treating a successful sponge passage as the required duct-proofing result because something reached the other end. Correction: Read the recorded tool and procedure and compare them with the specified proofing requirement. If only sponge passage is documented, flag the missing proofing evidence for the authorized testing crew instead of changing the result to passed.
  1. Mistake: Using the HH-A to HH-B proof sheet to clear a route that also continues from HH-B to HH-C. Correction: Split the review by segment and match both endpoint IDs and the duct or innerduct ID to each test record. Keep the second segment unresolved until its own required evidence is available.
